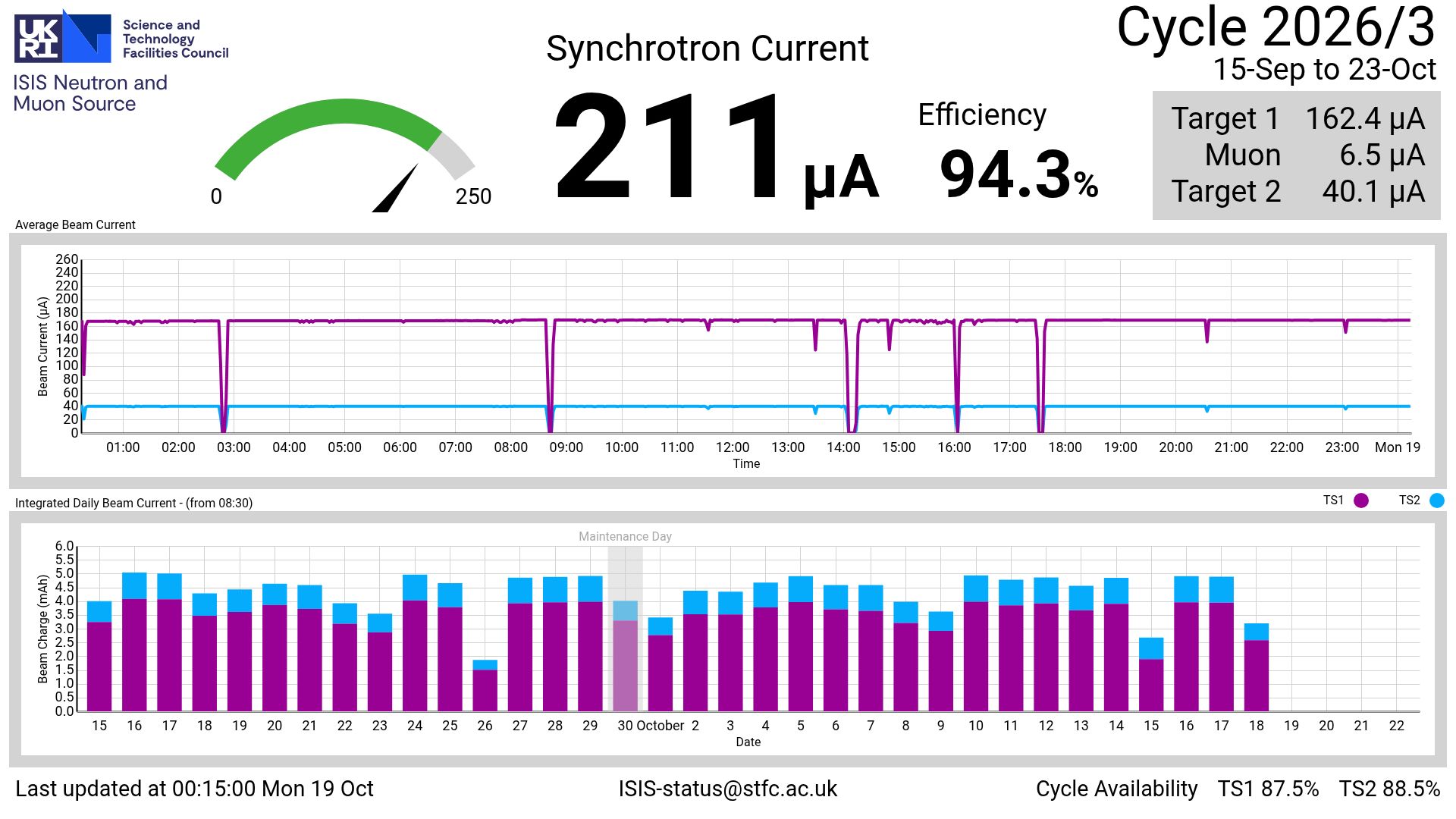

Beam status

Beam status

MCR News

23 November 2026 05:31
    Machine update:-

    We have a problem with the RGA on Target 1. Experts have been contacted
    and are on route to help with repairs. We are changing mode for beam to
    target 2 only.


21 November 2026 13:18
    Beam restored to both targets. @ 13:15


21 November 2026 12:38
    Expert is on site investigating the issue with the EPB2 PSU.

    Update @ 13:30


21 November 2026 11:31
    We are currently experiencing an issue with one of the EPB2 magnet power
    supplies. Beam to TS2 will be disbaled until the power supply fault is
    rectified. Update at 12:30.


21 November 2026 09:47
    The issue on Target 2 is with the Decoupled moderator. Experts are
    currently on route to investigate. Beam back on to both Targets although
    Decoupled moderator not operational.

    Update @11:30


21 November 2026 09:20
    There is a issue with the decoupled moderator on Target 2. We are in
    contact with experts to try and resolve the problem. Beam running to TGT1
    only while investigatng.
    Update @ 10:00


21 November 2026 07:07
    Machine update:-

    Beam restored to both target stations.


21 November 2026 06:07
    Machine update:-

    Experts are on site to assist with repairs to the Injection Dipole magnet.
    Update @ 07:00hrs.


21 November 2026 05:33
    Machine update.

    We have been suffering water flow problems that have effected Target 1 and
    now the Injection Dipole magnet. Experts are investigating to rectify the
    faults. Update @ 06:00hrs.


18 November 2026 12:26
    Attention: Riken is now cleared for beam.


17 November 2026 19:55
    Normal running on both Targets @ 19:45


17 November 2026 19:13
    TGT1 is very close to running at normal beam levels, the HEDS line
    required a bit more out gasing.
    Update @ 19:45


17 November 2026 18:33
    Full R/Rate Beam achieved on TGT2. TGT1 will be ready in approximately
    30mins.


17 November 2026 16:43
    Machine setup is continuing. There is a slight issue with Linac RF
    phasing, which experts are currently working on. Beam will be ramped up
    once this issue is resolved.
    Progress updated 18:30


17 November 2026 13:00
    Machine update.

    The vacuum repair in the Hed's line has been repaired. All areas are
    locked up and machine physics personnel are setting up the machine. Beam
    intensity to targets will vary whilst setup continues.


17 November 2026 07:50
    Machine update.

    Unfortunately, with the machine setup after the Ion source change
    yesterday, the beam was accidently miss-steered in the alignment process.
    This has resulted in a vacuum leak on an Aluminium seal in the Hed’s line.
    Machine experts have worked overnight to repair the fault, but
    unfortunately, it has been decided this morning that the seal needs
    replacing.  This process should take approximately 6-8 hours with pump
    down time.
    The user run will start at 08:30hrs, but beam is not expected until early
    evening. Updates will follow throughout the day.


17 November 2026 06:02
    ION source is in and giving a good output. We currently have an issue with
    vacuum in the synchrotron. A vacuum engineer is on site setting up to
    carry out a leak test. Update at 08:00.


16 November 2026 22:04
    Ion has been changed successfully. Have had various issues this evening,
    currently holding us off is RF system flow. Machine physicist is however
    in the process of setup up machine again.


16 November 2026 15:06
    Machine update:-

    Low energy beams group are in the process of changing the Ion source
    again. When we have a stable output the machine will be restored to an
    operational status.


15 November 2026 22:39
    Beamlines cleared for beam:
    S1 MAPS
    S4 MERLIN
    S5 MARI

    N6A IRIS
    N8 TOSCA

    E2 SANS2D
    E8 WISH


14 November 2026 15:30
    Attention:

    Status of TS2 beamlines:

    E1 Zoom - Cleared for beam, Shutter open
    E2 Sans2D - Not cleared, Shutter closed, Radiation survey required
    E3 Polref - Cleared for beam, Shutter open
    E4 Inter - Cleared for beam, Shutter open
    E5 Offspec - Cleared for beam, Shutter closed
    E6 Larmor- Cleared for beam, Shutter closed
    E8 Wish - Not cleared, Shutter closed, Radiation survey required

    W1 Chipir - Cleared for beam, Shutter open
    W5 Imat - Cleared for beam, Shutter closed
    W6 Let - Cleared for beam, Shutter closed
    W7 Nimrod - Cleared for beam, Shutter open
    Nile - Cleared


13 November 2026 18:27
    Attention:

    Status of TS1 Beamlines:

    N1 Sandals - Cleared for beam, Shutter open
    N2A Alfred - Cleared for beam, Shutter closed
    N3 Surf - Not cleared by Instrument Operations
    N6 Iris/Osiris - Cleared for beam, Shutter closed
    N6A Iris - Not cleared, Shutter closed, Radiation survey required
    N6B Osiris - Cleared for beam, Shutter closed
    N7 Polaris - Cleared for beam, Shutter open
    N8 Tosca - Not cleared, Shutter closed, Radiation survey required
    N8A Ines - Cleared for beam, Shutter open
    N9 Emma - Not cleared by Instrument Operations

    S1 Maps - Not cleared, Shutter closed, Radiation survey required
    S2 Vesuvio - Cleared for beam, Shutter open
    S3 Sxd - Cleared for beam, Shutter open
    S4 Merlin - Not cleared, Shutter closed, Radiation survey required
    S6 Mari - Not cleared, Shutter closed, Radiation survey required
    S7 Gem - Cleared for beam, Shutter open
    S8P EnginX/Hrpd - Cleared for beam, Shutter closed
    S8X EnginX - Cleared for beam, Shutter closed
    S9 Pearl - Cleared for beam, Shutter open
    Riken - All requires Radiation survey

    Any Target Station 2 beamlines that do not require Radiation surveys will
    be cleared this evening and requested shutters will be left open.


13 November 2026 15:53
    Attention:

    South side Muon beamlines HiFi, MuSR, EMU and Muon Bending magnet are
    cleared for beam.


23 October 2026 07:51
    Please be reminded that the user run will end at 08:30hrs this morning.


20 October 2026 10:10
    We are dealing with an issue on the Synchrotron Fundamental RF systems. We
    hope to restore beam within the next 30 minutes.


16 October 2026 10:00
    The Klixon issue from last night has now been fully resolved, all elements
    of the EPB are back on and the machine is now running as normal.


16 October 2026 08:43
    The Klixon issue from last night has not fully resolved, the machine has
    been setup to run with an element of the EPB switch off.


16 October 2026 01:47
    TS1 users: The klixon fault we developed earlier has not yet been
    resolved. The problem we face is it is in an area of high radiation (just
    underneath the intermediate target) so accessibility is difficult. After
    consulting with with relevant parties we are going to reconvene in the
    morning where more staff members will be available to implement a
    solution. This will mean beam will remain off overnight to TS1. Please
    check beam news in the morning for any updates.


15 October 2026 23:03
    Target 2 beam is back on. Target 1 is off as we have a klixon fault on a
    downstream EPB1 magnet. We are consulting with Our Mechanical Engineers
    and Machine Physicists to see if we can find a solution


15 October 2026 21:47
    Our equipment specialist is on site investigating the EPB2 power supply
    fault. Update when we have more information.


15 October 2026 21:06
    We have a failed power supply on EPB2. We have done a mode change to run
    to TS1 only whilst we investigate. We will update TS2 users when we have
    more information.


15 October 2026 12:52
    Beam back on @12:50


15 October 2026 12:27
    Works continue on the RF system PSU. Update @ 12:45


15 October 2026 11:45
    All but one of the RF systems are back on and working. Experts are
    currently repairing a PSU in the RF system.
    Update @ 12:15


15 October 2026 11:10
    There is currently a issue with the RF systems control. Experts are
    investigating.
    Update @ 11:45


15 October 2026 09:13
    The issue with the Target 2 shutter control system has been resolved.


15 October 2026 08:48
    There is an issue with Target 2 shutter control system. Expert on route to
    investigate. Update @ 09:30


14 October 2026 02:34
    Beam ON


14 October 2026 02:07
    A power supply has gone faulty in one of the linac modulators. Crew are
    just in the process of changing it. Update at 02:45.


12 October 2026 05:31
    Beam ON


12 October 2026 05:24
    We are experiencing an issue with one of the TS1 RGA's and we are in
    contact with the on-call equipment expert regarding this.

    Update @ 06:00.


09 October 2026 23:10
    Beam ON


09 October 2026 22:46
    The Linac modulator is back on but we are having issues controlling the
    tank phase. Beam is expected to be intermittent whilst experts investigate
    the cause of this.


09 October 2026 21:33
    BEAM OFF - Equipment experts are working on a fault with one of the Linac
    modulators. The issue is expected to be fixed shortly.

ISIS operating schedule

Our upcoming operating schedule. Cycles begin/end at 08:30 on the date specified

Cycle Start End Target station(s) Maintenance day(s) Comments
2026/4 17 Nov 2026 18 Dec 2026 TS1 & TS2 02 Dec 2026 —
2026/5 02 Feb 2027 25 Mar 2026 TS1 & TS2 17 Feb & 10 Mar 2027 —
LONG SHUTDOWN
2027/1 16 Nov 2027 17 Dec 2027 TS1 & TS2 1 Dec 2027 —
2027/2 22 Feb 2028 31 Mar 2028 TS1 & TS2 8 Mar 2028 —

ISIS operating schedule - future years

We plan to have an extended shutdown for accelerator and beamline work from March to October 2027.  The next proposal access call will open in March 2027 to allocate time from November 2027 to March 2028.

Machine physics schedule

Accelerator physics experiments are performed before and after each user run. Expand this section to see the latest schedule.

Date Shift Mode Rep Rate Task Contacts Notes
9/11/26

Monday

00:00–08:30 4B MS/32
08:30–16:30 4B MS/32 Initial injector and synchrotron setup (incl. MTG shift) HVC, EA Check IPM offsets
16:30–00:00 4B MS/32 Initial injector and synchrotron setup (incl. dp/p) BK, SK Run to IHBS4
10/11/26

Tuesday

00:00–08:30 4B MS/32
08:30–16:30 4B MS/32 Synchrotron setup (incl. SCPM bump measurements) HVC, HR
16:30–00:00 4B MS/32 Synchrotron setup and EPB1 alignment CMW, SK
11/11/26

Wednesday

00:00–08:30 4B MS/32
08:30–14:00 5 MS/32 Synchrotron setup and EPB2 alignment HVC, CJ
14:00-16:30 5 MS/32 RF setup AS, EY
16:30–00:00 5 MS Synchrotron setup for increasing rep-rate DJA
12/11/26

Thursday

00:00–08:30 5 MS
08:30–14:00 5 MS Synchrotron setup HVC, HR
14:00-16:30 5 MS RF setup AS, EY
16:30–00:00 5 MS Synchrotron setup BK, EA
13/11/26

Friday

00:00–08:30 5 MS
08:30–16:30 5 MS Synchrotron setup CMW, DK
16:30-18:30 5 MS RF setup AS, EY
18:30–00:00 5 MS Synchrotron setup, insert intermediate target HVC, EA
14/11/26

Saturday

00:00–08:30 5 MS Outgas all intermediate targets Crew
08:30–16:30 5 MS Synchrotron setup BK, HR
16:30–00:00 5 MS Synchrotron setup DJA
15/11/26

Sunday

00:00–08:30 5 MS
08:30–16:30 5 MS Synchrotron setup HVC, SK
16:30–00:00 5 MS Health Physics Surveys HP Section

Previous cycles

Select to see prevous ISIS cycle dates



Cycle Start End Target station(s) Maintenance day(s) Comments
2026/3 15 Sep 2026 23 Oct 2026 TS1 & TS2 30 Sep 2026
2026/2 — — — — Cycle cancelled
2026/1 05 May 2026 12 Jun 2026 TS1 & TS2 20 May 2026
2025/5 17 Feb 2026 30 Mar 2026 TS1 & TS2 4 Mar 2026
2025/4 18 Nov 2025 19 Dec 2025 TS1 & TS2 03 Dec 2025
2025/3 09 Sep 2025 17 Oct 2025 TS1 & TS2 24 Sep 2025
2025/2 01 Jul 2025 08 Aug 2025 TS1 & TS2 16 Jul 2025 Cycle cancelled
2025/1 29 Apr 2025 06 Jun 2025 TS1 & TS2 14 May 2025
2024/5 18 Feb 2025 28 Mar 2025 TS1 & TS2 05 Mar 2024
2024/4 19 Nov 2024 20 Dec 2024 TS1 & TS2 04 Dec 2024
2024/3 17 Sep 2024 20 Dec 2024 TS1 & TS2 04 Dec 2024
2024/2 09 Jul 2024 09 Aug 2024 TS1 & TS2 05 Mar 2024
2024/1 23 Apr 2024 31 May 2024 TS1 & TS2 08 May 2024
2023/5 13 Feb 2024 22 Mar 2024 TS1 & TS2 28 Feb 2024
2023/4 14 Nov 2023 19 Dec 2023 TS1 & TS2 29 Nov 2023
2023/3 19 Sep 2023 20 Oct 2023 TS1 & TS2 04 Oct 2023
2023/2 27 Jun 2023 04 Aug 2023 TS1 & TS2 12 Jul 2023
2023/1 25 Apr 2023 26 May 2023 TS2 Only
(TS1 Commissioning)
10 May 2023
